Lost Gold - Milling and Paving Dates

Lost Gold Owners,


Starting Friday, July 19, MR Tanner will begin milling/ removing a portion of the asphalt sections of your village roadways.

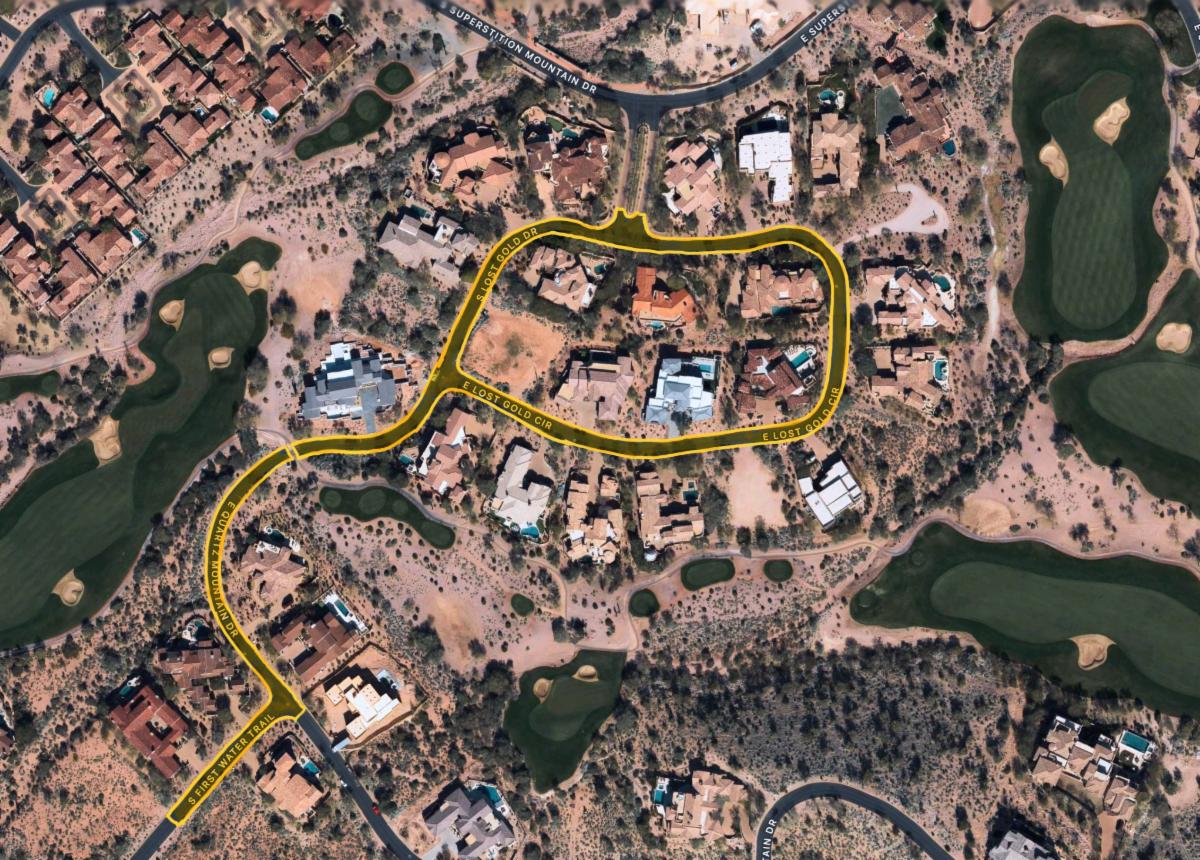

The following week, on July 31, MR Tanner will begin paving the yellow section of the road as marked on the map below.

See below for access planning for July 19 and July 31. Please read the information below, and the project notice provided by Frank Civil Consulting so you are fully prepared for the paving day on July 31.


Please contact the Association office if you have any questions,


Alex Wright, CMCA, CAAM

Interim Community Manager, Superstition Mountain


*Click the map below for a full-sized PDF of the 2024 Project Map.

July 19 - Milling

Access will not be restricted completely during the milling process. However, due to the tight nature of the roads in your Village, entering or exiting during the process may be met with delays while the equipment is in the road.


July 31 - Paving

Access will be restricted entirely for 24 hours beginning the morning of July 31 through the morning of August 1 (assuming no weather delays). During this time, vehicular access into and out of the village will be blocked entirely.

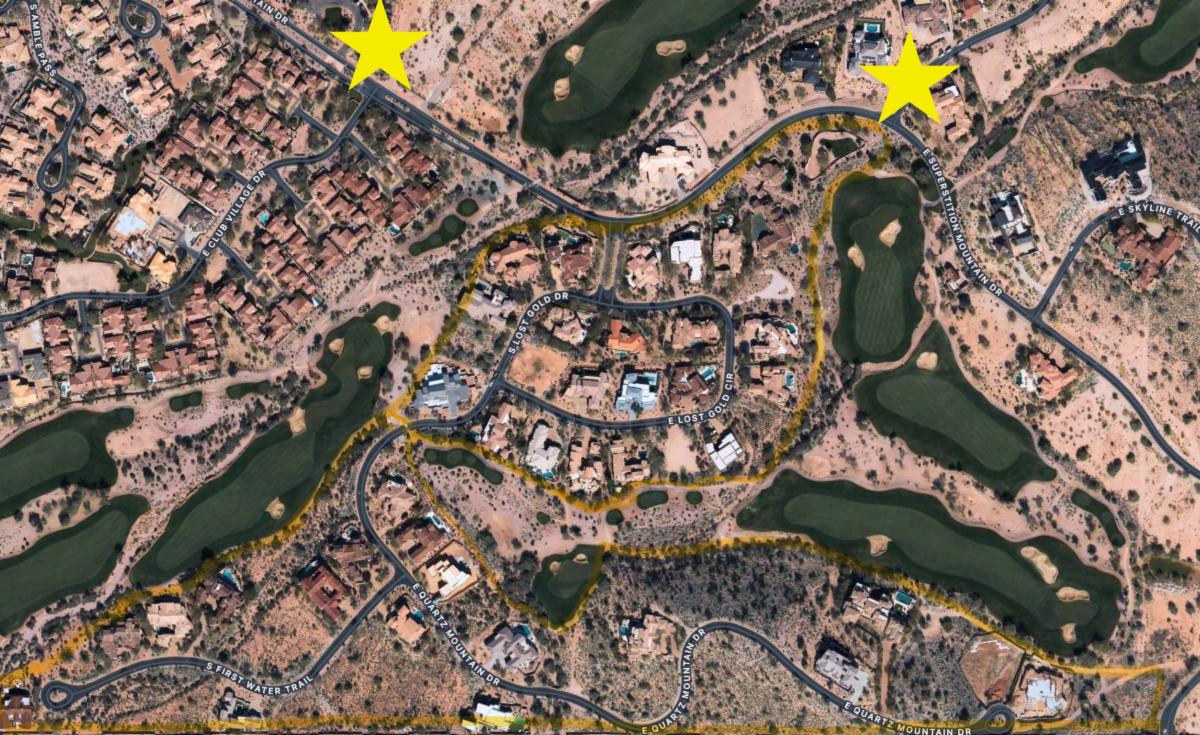

To facilitate residential access during this 24-hour time frame, the Golf Club is allowing Lost Gold Residents to park in the Sports Court parking lot. Alternatively, you may park in the Canyon View Estates entry. These areas are a medium walk.


Parking

If you are planning to be on property on July 31 AND need to enter or exit in your vehicle when access is restricted in your village, please plan ahead to park in one of the designated locations. Because access restrictions begin at 6:00 am, you will want to park your vehicle outside the village the night prior – Tuesday, July 30.

Schedule

What Comes Next?


  • 7/17 - 7/19: Pavement Removal (no closure, but delays expected, driving over dirt allowed)


  • 7/22 - 7/30: Ground Prep & Grading Work (no closure, driving over dirt allowed)


  • 7/25: Phase 1 Asphalt Paving - Golden Eagle Village
  • (Green Section of Map closed 6am to 6am)


  • 7/26: Phase 2 Asphalt Paving - First Water Village
  • (Blue Section of Map closed 6am to 6am)


  • 7/31: Phase 3 Asphalt Paving - Lost Gold Estates
  • (Yellow Section of Map closed 6am to 6am)


  • 8/1: Phase 4 Asphalt Paving - SMD - Prospector Village Impacted
  • (Red Section of Map closed 6am to 6am)


  • 8/2: Phase 5 Asphalt Paving - SMD - Sunset, Greythorn, Wildflower Impacted
  • (Purple Section of Map closed 6am to 6am)


  • TBD: Re Stripe Lines (No closure, open to traffic)



  • 8/12 - 8/16: Utility Collar Raising (No closure, open to traffic)


*The schedule is subject to change due to inclement weather or other unforeseen circumstances. Any changes will be communicated via email blast.

Lost Gold FAQs

I don't live in the area adjacent to the yellow highlighted for road removal. Will I be affected?


Yes, you may run into localized delays during the milling on July 19. With the fresh pavement at the village entrance, you will not be able to enter or exit Lost Gold Estates from 6:00 a.m. on Wednesday, July 31, through 6:00 a.m. on Thursday, August 1.


If I am not in Gold Canyon / won't be in the property on July 31, is there anything I need to do for this project?


No. If you are not in the community and will not require vehicular access to your home on July 31, you need not do anything else.


Friday, July 19 is trash and recycle pickup day - are accommodations being made?


Yes. We have spoken with RAD / Waste Connections of Arizona, and MR Tanner. You can place your refuse and recycle out as usual on Thursday, July 18, and they will be picked up first thing Friday morning. After trash collection is complete, MR Tanner will begin the milling process.


Please assist by bringing your cans in off the street as soon as possible following pickup.

Resources & Communications

6.30.24 | Road Work - Announcement Email Blast
7.11.24 | Road Update 2 - Milling Begins Next Week!
2024 Road Work | Projects Tab on Community Website
Community Notice - MR Tanner, Frank Civil Consulting
Superstition Mountain is proudly and professionally managed by
Contact Information

Association Office: 480-983-6773
Gate Staff: Superstition.Mountain@CoveySecurity.com 480-983-9270
